Capital Projects



  • Water Plant No 2 (active construction)
    • Project Start Date: on 05/24/23.
    • Estimated Project Completion Date: TBD
    • Project Status: reviewing the specs for the production wells # 1and 2, reviewing the data specs for the new equipment, drillers on -site in January-February for the production wells installation.
  • Dukes Bay New Lift Station/Gravity Sanitary Sewer and Force Main (Active construction)
    • Project Start Date: Spring of 2022
    • Estimated Project Completion Date: 10/30/23.
    • Project Status: Finalizing bullet points that need to be address before closing out the project.
  • Knights Creek Emergency Repair (active construction)
    • Project Start Date: February 2023
    • Estimated Project Completion Date: TBD
    • Project Status: emergency pumping ongoing; sewer pipe replacement will occur in late October through November/December

  • Exit 16 Valdosta Gateway
    • Project Start Date: notice to proceed 06/08/2023
    • Project Completed in December of 2023

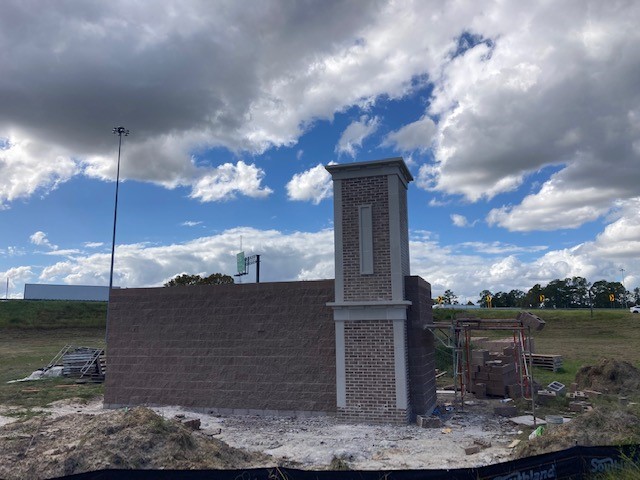

    • Project Status: masonry construction on the signs is ongoing in October and November, landscaping work will occur in November
    • Cost:  $613,584.40
  • Lake Park Rd Culvert Replacement
    • Project Start Date:  construction began July 2023
    • Estimated Project Completion Date: November 2023
    • Project Status: utilities relocated, culvert barrel installed, culvert end treatments construction ongoing, road and sidewalk repair scheduled in November
    • Cost: $651,978.00

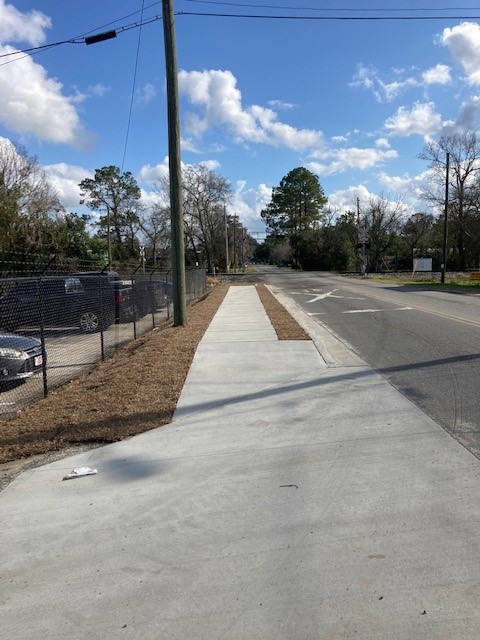

  • West Street Sidewalk (anticipated construction)
    • Project Start Date: TBD
    • Estimated Project Completion Date: TBD
    • Project Status:  project has been delayed for utility relocations non-city owned; that utility submitted a relocation plan in October 23, and will be proceeding with relocation in late-2023/early-2024
    • $1,270,271.20
    • Estimated Project Completion Date: late summer 2024
    • Project Status: equipment and materials fabrication and delivery will take until early-2024; construction anticipated in spring/summer of 2024
    • $1,279,247.20
    • Project Start Date: Council awarded 06/08/2023

  • Gornto & Baytree Traffic Signal & Intersection Improvement (active contract, anticipated construction)
    • Project Start Date: Council awarded 06/08/2023
    • Estimated Project Completion Date: late summer 2024
    • Project Status: equipment and materials fabrication and delivery will take until early-2024; construction anticipated in spring/summer of 2024
    • $1,279,247.20 - Awarded to Reames & Sons Construction on 8/24/2023
    • Start date has not been determined.

  • Old Clyattville (anticipated construction)
    • Project Start Date: TBD
    • Estimated Project Completion Date: TBD
    • Project Status: final design and permitting by state and federal agencies is ongoing
    • $5,712,207.32  -  Awarded to Reames & Sons Construction on 3/21/2024
    • Start date has not been determined

  •  Dogwood Drive (area improvements)
    • Funding Source: SPLOST
    • Project Cost; estimated $2M
    • Project Start Date: estimated construction start spring 2024
    • Estimated Project Completion Date: TBD
    • Project Status: project is designed, City Attorney office is completing final property acquisitions
Engineering
229-259-3530
229-333-1884
City Engineer
Location

Valdosta City Hall Annex
300 N. Lee Street
Valdosta, GA 31601

Upcoming Events
Repeats every month on the first Friday 48 times.
01/03/2025 - 5:00pm to 8:00pm
02/07/2025 - 5:00pm to 8:00pm
03/07/2025 - 5:00pm to 8:00pm
